PROJECTS INFORMATION
This page serves as the central source for updates on the various projects happening within the City of Linden.
Projects will be updated as information becomes available.
Genesee County Water Connection Project
The county connection to the City of Linden water system was completed on April 29, 2025. This connection changed our municipal water system from a groundwater supply to a surface water supply. This change in water source will significantly reduce the mineral content “hardness” of the water and should eliminate the need for private water softeners in most cases. Based on this change, we recommend that residents place their water softeners in the bypass position to determine if the new water supply meets their needs without additional treatment.
In addition to water quality improvements, residents should start noticing an increase in water pressure. Based on current data, system pressures have increased 7-12 psi throughout the community. The city plans to continue making incremental increases until satisfactory pressures are reached.
Lindenwood Neighborhood Project
Work in the Lindenwood neighborhood has been substantially completed. The project included the installation of new water mains, significant curb and gutter replacement, drainage improvements, and new asphalt roadways. City staff and engineers are now working with the contractor to complete miscellaneous “punch-list” items to complete the project
2024 LINDENWOOD NEIGHBORHOOD IMPROVEMENTS PLAN SET
West Rolston Road Repaving Project
The project has been designed and awarded, and the SAD process has been completed. The W. Rolston Road project kicked off on June 2, 2025. The project will include the complete reconstruction of W. Rolston Road from N. Bridge to the City limit. Reconstruction will include subbase and drainage improvements, significant curb and gutter replacement, and a new asphalt roadway. At times, the project will require temporary road closures to accommodate various stages of construction. Workers plan to start at N. Bridge St. and progress to the west. A detour route will be posted utilizing Hogan Road on the west end of the project. Travelers from the north can access Hogan Rd via Lahring Rd, while travelers from the south can access Hogan Road via W. Broad St. As work progresses to the west, access to N. Bridge will be reestablished for travel.

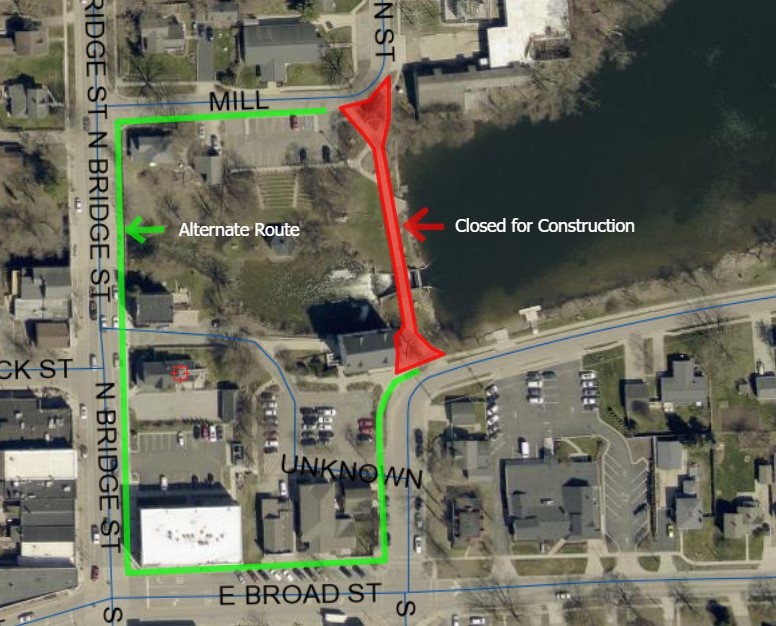

Click here to see the Rolston Road Detour Map
Tentative Construction Schedule
• June 2nd- Mobilization/Traffic Control
• June 3rd – 5th - Pavement Crushing
• June 6th- 17th - Subgrade Undercutting/Machine Grading
• June 18th – 27th - Geotextile/Subbase Placement
• June 30th - July 7th - Concrete Curb Work/Walk
• July 8th - 14th - HMA Paving
• July 15th - 21st - Restoration
• July 22nd – 31st - Pavement Markings and Cleanup
* Schedule subject to change due to weather or other unforeseen circumstances
Please remember to use caution when traveling through the work zone.
Linden Mills Rehabilitation & Redevelopment Project
The City continues to work with our architectural partner, H2A Architects, and project manager Cunningham Limp on the project! This project has been made possible thanks to a grant received from the State of Michigan to fund critical improvements to this historic treasure. These improvements address structural, life-safety, facility and accessibility issues. The rehabilitation activities will include repair and painting of the exterior wood siding, replacement of non-historic windows and rehabilitation of historic windows. Work will also include a new insulated roof, interior structural repairs, replacement of porch foundation wall and porch slab, and repointing of the stone foundation. The project
will include an addition to the west side of the building to accommodate a new elevator and fire stairs, ADA restrooms on each floor, as well as ADA enhancements to porch and surrounding footprint. Exterior improvements include new steps, stair replacement, a loading/unloading area, dumpster enclosure with screening walls and gate, transformer pad and mechanical equipment area with wood fence, improved storm sewer infrastructure, bike rack and additional improvements. All of these improvements have progressed through necessary City Boards and Commissions. All decisions were made mindfully with the common goal “to preserve materials, features and form, to create balance between compatibility and differentiation; in adherence with historic building design guidelines and the Secretary of Interior Standards for Rehabilitation,” stated by Jackie Hoist of H2A, as not to jeopardize National Historic Registry status. City staff and engineers are currently working with the State to design and install a temporary cofferdam, which will facilitate structural foundation repairs and the installation of new foundations for the addition. Once the cofferdam designs are completed and approved, the city will begin soliciting bids for the entire project. The project is also currently pending EGLE permits that are required for the foundation work.
At the May 12, 2025 meeting, City Council voted to extend an offer to the Historical Society and Genesee District Library to return to the building! The museum will occupy the fourth floor, the library the first floor with options of activities and events in the new community/flex space in the basement. The third floor will remain vacant while it is actively advertised as a lease opportunity for commercial use. Stay tuned for updates!
CLICK TO VIEW H2A ARCHITECTS FULL PROPOSAL
Mill Renovation Flyer from the Genesee District Library (GDL)
PLEASE CLICK TO READ PRESS RELEASE ISSUED JUNE 12, 2025
Latest Mill Building Elevation & Design Drawings
Mill Advisory Committee Information
This Committee was re-established in 2022 for the mission of gathering information to make recommendations to the City Council regarding grants, fundraising opportunities and priorities for work on the Mill Building, through the use of current plans, assessments and reports. During the March 9, 2023 meeting, Committee members unanimously approved moving forward a recommendation of request for proposal for expression and interest to the City Council. The Committee had fulfilled its mission and was allowed to dissolve.
ADDITIONAL RESOURCES:
Architectural Assessment Report (2015)
Facility Evaluation Report (2017)
Emergency Standby Generators
City Council recently approved the purchase and installation of emergency standby generators for the Rolston Road and Byram Lake sewer lift stations. These generators will ensure that the stations have continuous power even during power outages. Emergency generators for our two remaining stations are planned in 2025.
Safe Routes to School Project
The Safe Routes to School Project for Hyatt Lane and Stan Eaton Drive continues to move forward. The city expects to bid the project this fall. Once approved, construction is expected to follow in winter or early spring.
Underground Fiber Project
Surf Internet is currently in the process of installing underground internet fiber throughout the city for residential connection. The installation is complete is several areas of the community and will continue to be installed in remaining areas throughout the construction season. Click the link for additional information:Surf Internet Fiber Optic Coverage Map - Surf Internet
Storm Drain Clean Up
Did you know that the storm drains found in our roads, parking lots and yards drain directly into our local lakes and rivers? Storm drain systems are designed to quickly remove excess water runoff to prevent areas from flooding. However, this draining process also allows other foreign objects access to our waterways. How can you help? Take the time to clean up any excess yard fertilizer, grass clippings, leaves, trash and other pollutants from storm drain covers. Take precautions to prevent any soaps, oils, grease, dog waste or other contaminants from entering the storm system. These little efforts will help ensure the only thing entering our surface waters is rainwater!
(Updated: July 2025)
